The Year Two to Five Plan sets out 41 actions to be delivered between November 2021 and December 2025 across five priority areas. ‘Action status’ is reported by the lead agency against the Year Two to Five Plan. Given the changes to action completion dates in the implementation plan from Year Two to Year Three, comparisons of action statuses between years should not be made.
Agencies reported that 15 actions were completed as at 30 June 2023:
actions 3.5, 3.7, 3.10 and 3.11 within the Priority Three workstream
actions 4.4, 4.8 and 4.10 within the Priority Four workstream
actions 5.3, 5.4, 5.5 and 5.6 within the Priority Five workstream.
Of the remaining 26 actions, as at 30 June 2023, agencies reported that:
ten are “in progress - on track”
eight are “in progress - minor delays”
five are in “progress - significant delays”
three have “not commenced”.
FSIM notes that four actions (actions 2.3, 3.6, 4.6 and 5.1) did not meet their completion date detailed in the Year Two to Five Plan at the end of the reporting period.
Table 7 provides the agency-agreed definitions for the status of actions.
Table 7: Government implementation status definitions[12]
Status | DJCS progress assessment definitions |
---|---|
Completed | Action is finished and formally acquitted through completion and signing of the acquittal form. |
In progress – On track | Action has commenced and is tracking to be completed by the 'completion date' as per the Year Two to Five Plan. |
In progress – Minor delays | Action has commenced and is experiencing minor delays that may impact delivery by the 'completion date' as per the Year Two to Five Plan. |
In progress – Significant delays | Action has commenced and is experiencing significant delays and it is highly unlikely that the 'completion date' as per the Year Two to Five Plan will be met. |
Not commenced | Action has not yet commenced. |

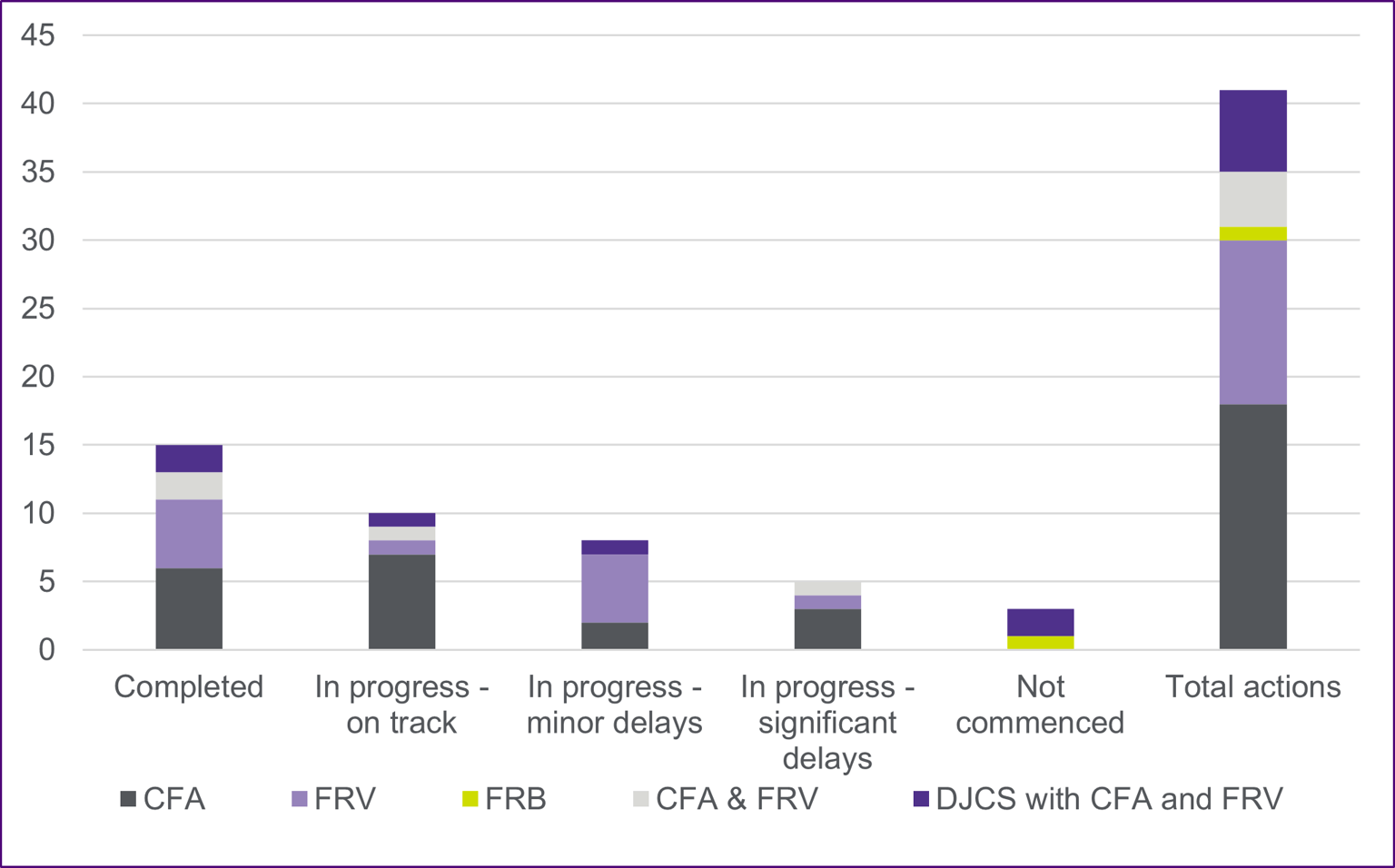

Figure 2 provides the status of all Year Two to Five Plan actions, as at 30 June 2023.
Status of Year Two to Five Plan actions
Updated
